2003/04 – 2005/06 SERVICE PLAN
Ministry of Transportation

Resource Summary

Core Businesses 2002/03 Restated Estimates1 2003/04 Estimates 2004/05 Plan 2005/06 Plan
Operating Expenses ($000)
Highway Operations 447,004 454,815 417,827 420,072
Transportation Improvements 16,481 13,536 12,297 12,197
Motor Carrier Regulation 595 1,804 1,610 1,610
Public Transportation2 250,162 348,157 343,518 341,414
Executive and Support Services 20,390 16,054 14,599 14,558
Totals 734,632 834,366 789,851 789,851
Full-time Equivalents (FTE)
Highway Operations 1,103 964 602 602
Transportation Improvements 340 290 280 280
Motor Carrier Regulation 4 19 18 18
Executive and Support Services 136 112 66 66
Totals 1,583 1,385 966 966
Ministry Capital Expenditures
(Consolidated Revenue Fund) ($000)
Highway Operations 4,140 5,150 2,543 4,888
Transportation Improvements 1,350 974 595 575
Executive and Support Services 2,375 326 1,275 1,050
Totals 7,865 6,450 4,413 6,513
Other Financing Transactions ($000)
Public Transportation 155,070 46,390 5,560 4,190
Revenue ($000)
Total Ministry Revenue3 46,989 47,816 48,889 50,049

1   These amounts have been restated, for comparative purposes only, to be consistent with the presentation of the 2003/04 Estimates. Schedule A, Consolidated Revenue Fund Expense, FTE and Capital Expenditure Reconciliations – 2002/03, of the Estimates presents a detailed reconciliation.
2   Public Transportation: includes government transfers to British Columbia Transit and British Columbia Ferry Services Inc., as well as amortization and debt servicing costs for both British Columbia Transit and Rapid Transit Project 2000.
3   The majority of the ministry’s reported revenue comes from Coquihalla tolls ($44.0 million in 2002/03; $47.41 million in 2005/06).

BC Transportation Financing Authority — Consolidated Income Statement1



2002/03 Budget 2003/04 Budget 2004/05 Plan 2005/06 Plan
Revenue ($000)
Dedicated revenue2 203,200 418,300 430,500 443,000
Capital contributions (amortization)3 181,054 174,808 171,145 165,270
Contractor fees4 19,000
Other5 6,130 4,120 3,616 3,616
Totals 409,384 597,228 605,261 611,886
Expenditures ($000)
Amortization 280,736 287,528 297,127 306,453
Financing expense6 154,119 160,479 176,679 188,783
Contracted services 75,887
Northern and heartland roads 75,000 75,000 75,000
Construction wages and benefits4 19,000
Operations and administration 6,332 3,820 3,616 3,616
Grant programs7 4,800 18,400 18,200 18,000
Totals 464,987 545,227 570,622 667,739
Net Income (Loss) ($000)
Net (Loss) Earnings (55,603) 52,001 34,639 (55,853)
Capital (Consolidated Capital Plan) ($000)
Capital Expenditures 254,020 297,800 300,700 272,700

1   Includes results of Highway Constructors Ltd. (HCL), a wholly-owned subsidiary.
2   Dedicated revenue includes motor fuel tax (3.25 cents/litre in 2002/03 and 6.75 cents/litre in 2003/04 to 2005/06) and a provincial sales tax on short-term car rentals.
3   Capital contributions include the offset for highway infrastructure transferred from the Province of British Columbia and other capital contributions received from outside agencies. These contributions are amortized to income at the same rate as the related highway infrastructure is amortized as expense.
4   HCL provides construction labour on various infrastructure projects and recovers the costs. HCL will cease operations once committed contracts are complete.
5   Includes economic development, property and investment revenue, recorded net of related expenses.
6   Interest on borrowing used to finance construction work in progress is capitalized. Upon completion, interest capitalization ceases, and related interest costs are expensed.
7   Includes grants paid under the infrastructure works program, the newly incorporated territories program, and, commencing in 2003/04, grants to airports, ports and other projects.

Rapid Transit Project 2000



2002/03 Budget 2003/04 Budget 2004/05 Plan 2005/06 Plan
Revenue ($000)
Recognition of deferred capital and pre-operating contributions 34,321 27,457 27,457 27,457
Expenditures ($000)
Amortization of deferred capital contribution 34,321 27,457 27,457 27,457
Net Income ($000)
Net Earnings

Click here to return to the top of this page.

Major Capital Projects

Under the Budget Transparency and Accountability Act, a major project is defined as any capital commitment or anticipated commitment that exceeds $50 million.

Project Name: Nisga’a Highway

Objectives:

To facilitate economic growth and development, the province is continuing a seven-year investment program with two components:

  • Upgrading the Nisga’a Highway to an all weather two-lane highway.
  • Construction of the new Greenville to Kincolith road to open up access to the Village of Kincolith. This project is financed under a cost sharing partnership comprising the federal and provincial governments and the Nisga’a Tribal Council.

Costs:

  • The estimated total project cost for the Nisga’a Highway Upgrade is $52 million.
  • The estimated total project cost for Greenville-Kincolith (new route) is $34.6 million ($17.5 million provincial share).

Benefits:

  • Safety, access and mobility improvements.
  • Increased economic development (e.g., tourism).

Project Name: Kicking Horse Canyon

Objectives:

The improvement program for the Kicking Horse Canyon involves upgrading the 26-kilometre section of the Trans Canada Highway between Golden at the junction of Highway 95 and the western boundary of Yoho National Park to a modern four-lane standard. This investment would represent a major service improvement to the Trans Canada Highway and is directed at:

  • responding to continual and severe safety problems;
  • minimizing road closures due to slides and accidents;
  • replacement of two major structures that are nearing the end of their service lives;
  • supporting the efficient movement of goods and services;
  • facilitating trade and commerce;
  • supporting tourism and associated local business opportunities; and
  • augmenting the capacity of a critical provincial/national gateway.

Costs:

The estimated capital cost of the improvement program is $730 million (2002 dollars).

The upgrade will proceed in three phases:

5-Mile (Yoho) Bridge ($61 million): The project is being cost shared with the Government of Canada under the Strategic Highway Infrastructure Program (SHIP): $22 million federal and $39 million provincial. Construction is in progress and forecast expenditures to March 31, 2003 are $19.5 million.

10-Mile (Park) Bridge ($150 million): Cost sharing with the Government of Canada is being pursued under the Strategic Infrastructure Fund (SIF), with the objective of concluding a contribution agreement in the near term and proceeding with implementation of the project. Project development activity is in progress and forecast expenditures to March 31, 2003 are $2.7 million. Financing and project delivery options through a public-private partnership are being investigated.

Golden to 5-Mile and 10-Mile to Yoho National Park ($520 million): Implementation is not proposed during the current three-year service plan and would be subject to securing cost sharing with the Government of Canada.

Benefits:

  • The net present value of the 5-Mile (Yoho) Bridge and 10-Mile (Park Bridge) sections is $110 million based on safety, travel time, reliability and economic development benefits.

Risks:

  • Technical Risk: Rock and slope stability and climatic conditions.
  • Financial Risk: Possible construction problems due to difficult topography and material costs.
  • Availability of federal funding.

Project Name: Okanagan Lake Bridge

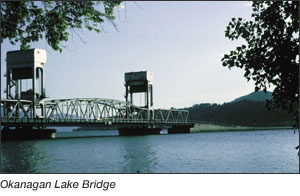

Photograph of the Okanagan Lake Bridge.

Objectives:

  • Widen the bridge from three to four lanes to reduce congestion in peak hours and through the summer. Includes construction of a couplet system in downtown Kelowna to improve traffic flow and the addition of a truck climbing lane on the west side of Okanagan Lake.
  • Reduce travel time from the South to the Central Okanagan and facilitate tourism, goods movement and business travel.

Costs:

  • The estimated total project cost is $100 million. Financing and project delivery options through a public-private partnership are being investigated.
  • Forecast expenditures to March 31, 2003 are $7.5 million for project development and design. A contract for the initial stages of bridge construction is expected to be let in 2003/04.

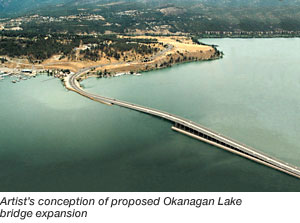

Artist's conception of proposed Okanagan Lake bridge expansion.

Benefits:

  • The net present value of the benefits of the project is $109.1 million, and includes improved safety, travel time savings and economic development.

Risks:

  • Technical Risk: The risks associated with the construction of floating bridges have been substantially reduced in recent years with the introduction of new flotation technologies.
  • Financial Risk: Possible construction problems due to engineering challenges.

Project Name: Sea-to-Sky Highway

Objectives:

  • As with the Kicking Horse Canyon project, upgrade the highway to improve safety, increase mobility and minimize road closures due to slides and accidents.
  • Promote economic development through improved access, especially in relation to tourism, and support the 2010 Olympic bid.

Costs:

  • The estimated total project cost is $600 million. Implementation strategy, which is expected to include financing through the private sector, will be finalized in the next few months. Federal funding is being pursued as well.
  • Forecast expenditures to March 31, 2003 are $14 million for planning and project development.

Benefits:

  • The net present value of the benefits of the project is $900 million, and includes improved safety, travel time savings and economic development.

Risks:

  • Technical Risk: Rock and slope stability and climatic conditions.
  • Financial Risk: Possible construction problems due to difficult topography and material costs.

Project Name: Rapid Transit Project 2000 (RTP2000)

Objective:

To construct the 21.6 kilometre Millennium Line extension to the SkyTrain rail transit system in the Lower Mainland, and to conduct feasibility studies of two planned further extensions of SkyTrain.

Costs:

  • The total project cost of the Millennium Line is currently forecast to be $1.12 billion, versus its approved budget of $1.17 billion.
  • Transfer of the capital assets to TransLink by way of an operating lease agreement is pending.

Benefits:

  • Rapid transit service for current and future commuters.
  • Reduced congestion and automobile exhaust emissions, and reduced demand for new highway infrastructure.
  • Compact urban development focused on transit stations, and reduced pressure on green space at the perimeter of Greater Vancouver.

Risks:

  • As of early 2003, the Millennium Line is mostly complete and running smoothly to Commercial Station. Construction and financial risks are limited to one remaining station and associated guideway at Vancouver Community College. A construction start on this section is anticipated in 2003 under a new right-of-way agreement with the Burlington Northern Santa Fe railroad.

Click here to return to the top of this page.


Significant Capital Programs

In addition to the major projects described above, the following capital programs will have a significant impact on the transportation system during the term of this service plan.

Northern and Heartland Roads

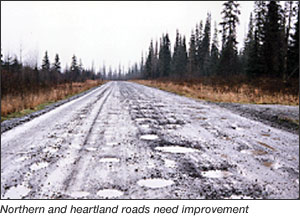

Northern and heartland roads need improvement.

Objective:

  • To improve road access for resource industries and for northern and rural residents.
  • Through a significant increase in annual investment, to improve the northern and heartland road network so that 43 per cent of the network is in good condition in April 2006 compared with 34 per cent in March 2003; and in addition, to improve the condition of 2,600 kilometres of roads that are currently in very poor condition.

Costs:

  • Budget in 2002/03 totalled $10 million network-wide plus $20 million dedicated to oil and gas roads.
  • An additional $75 million per year will be invested in 2003/04 through 2005/06.

Benefits:

  • Safe and reliable road access to heartland areas.
  • The general improvement of roads, the extension of the driving season on many roads and the lifting of load restrictions is expected to leverage investment in oil and gas, mining exploration and development, forestry, agriculture and wilderness-based tourism.
  • The reconstruction of the road network will reduce the requirement for unplanned, high-cost emergency repairs.
  • By setting program priorities in consultation with Regional Transportation Advisory Committees, the province will solidify partnerships with industry and local government.

Risks:

  • The program may be subject to unplanned adjustments in response to flooding, slides and other natural events.

Border Crossing Program

Objectives:

  • Enhance the free flow of goods through B.C.’s busiest border crossings through 28 projects at the border or on highway approaches. The program will combine infrastructure improvements and investments in transportation technology.
  • Provide economic benefits to a range of goods-producing sectors, reduce border crossing delays for the trucking industry, and improve security.

Costs:

  • The estimated total program cost through 2006/07 is $242 million. Of this, British Columbia is to provide $135.5 million, while the federal government is to contribute $102 million under the Strategic Highway Infrastructure Program and the Border Infrastructure Fund. Other partners are to contribute $4.5 million.
  • Forecast expenditures to March 31, 2003 are $4 million, cost-shared among the province, the federal government and other partners under the Strategic Highway Infrastructure Program.

Benefits:

  • The net present value of all projects is $569 million.
  • The program may help to establish a pattern of federal participation in transportation programs that support interprovincial and international trade.

Risks:

  • Cost estimates are based on preliminary information.
  • Some partner funding has yet to be finalized.
  • Aggressive implementation is required to meet the federal program horizons.

Highway Rehabilitation

Objective:

  • To keep the provincial highway network safe and reliable, and to prevent deterioration from 2002/03 levels, when 76 per cent of highways and 80 per cent of bridges were in good condition. This is to be achieved through the resurfacing of approximately 5,000 kilometres of highway through 2005/06, including 24 bridge decks, the replacement or rehabilitation of 115 structures, and continued investment in seismic retrofitting and in safety improvements such as guardrail installation.

Costs:

  • Projected investment from 2003/04 through 2005/06 is $146 million per year.
  • Budget in 2002/03 was $135 million. (In the previous three-year service plan, projected investment in capital rehabilitation was given as $165 million. This included $30 million for northern and heartland roads, now described as a separate program).

Benefits:

  • Improved highway safety.
  • Protection and enhancement of economic activity on provincial highways.
  • Reduced incidence of highway failure and the requirement for closures and reconstruction.

Risks:

  • The program may be subject to unplanned adjustments in response to flooding, slides and other natural events.

Okanagan Corridor Improvements

Objective:

  • To improve safety and capacity improvements in the Okanagan corridor, beginning with the four-laning of Highway 97 north of Swan Lake.

Costs:

  • Projected expenditures from 2003 through 2006 are $50 million, excluding the reconstruction of the Okanagan Lake Bridge.
  • There were no major program expenditures in 2002/03.

Benefits:

  • Support for trade and tourism in a significant north-south corridor.
  • Reduced congestion in urban areas.

Needles Bridge Study

Objectives:

The ministry is undertaking a technical feasibility study on the option to replace the Needles Ferry, which links the communities of Fauquier and Needles, with a bridge. It is anticipated that a bridge will be feasible.

Costs:

  • Confirmation of the costs to build the bridge will occur after the technical feasibility study is complete.

Benefits:

  • The movement of people, goods and services will be unrestricted, unlike the current ferry operation.
